Concept to Launch in 6 Weeks: Private Label Lashes (X-Week)

Private Label Lashes

A realistic, repeatable timeline for launching private label lashes—without skipping QC, branding, or compliance basics.

Introduction

“Can we launch in X weeks?” is one of the first questions we hear from new lash brands.

Yes—often. A 4–6 week launch is realistic when you lock specs early and use stock packaging + custom labels/sleeves. If you require fully custom printed boxes, more SKUs, or slow approvals, plan 7–10+ weeks.

This guide shows: the exact week-by-week path we used to go from concept to launch in 6 weeks, plus the approval rules, QC checkpoints, and packaging decisions that prevent timeline slip.

Paste-ready box (short, high-converting)

Editorial transparency (how to read this case study)

  • What’s real vs anonymized: Timeline steps and deliverables reflect an actual 6-week launch; names, supplier identity, and sensitive commercial details are anonymized.
  • What’s firsthand: Our workflow (sampling/approval rules, packaging proof process, pilot QC checks, launch-prep checklist).
  • What’s generalized: “Common delays/mistakes” sections summarize patterns we repeatedly see across launches.
  • Commercial relationship: We may offer services related to private label lashes; recommendations aim to be practical regardless of who you work with.
  • Not legal/medical advice: Compliance and sensitivity guidance is informational; consult qualified professionals for legal/medical decisions.
  • Last updated: [Month Day, Year] (we update when labeling rules/platform requirements or best practices change).

Tip: You can swap “6” for your own “X.” The same structure works for 4–10 weeks—your biggest variables are custom packaging, SKU count, and approval speed.

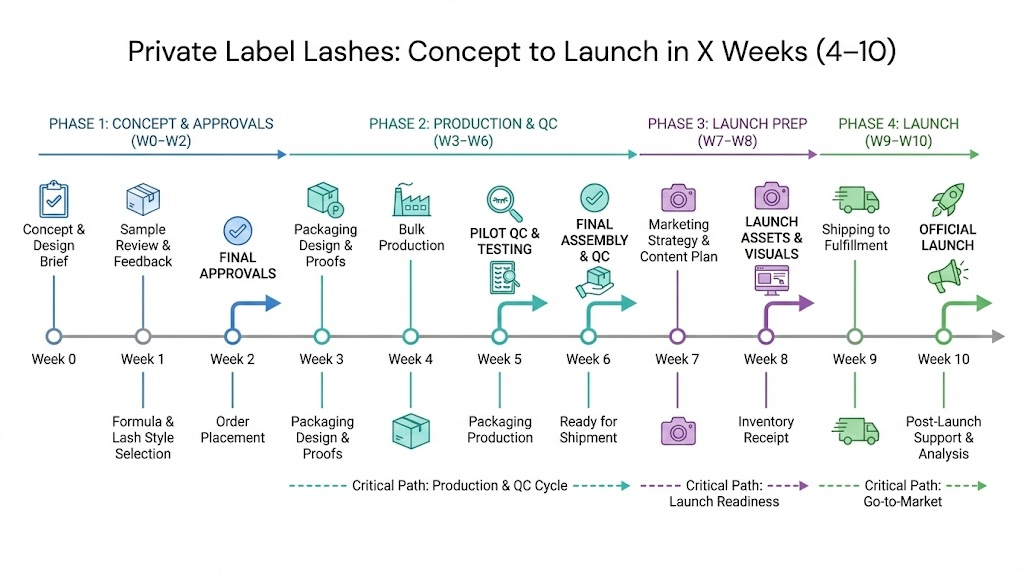

Private label lashes concept to launch timeline infographic 4 to 10 weeks

Quick Answer

The fastest safe path (most brands)

  • 4–6 weeks: proven lash specs + stock box + custom label; 2–4 SKUs
  • 5–7 weeks: stock structure + printed sleeve (more branding, some proof cycles)
  • 7–10+ weeks: fully custom printed box (premium unboxing, longest lead time)

Most common delay (what actually breaks timelines)

  • Packaging proof cycles: dieline, label copy, barcode, finish samples, sleeve proofs
  • Slow approvals (subjective feedback instead of “go/no-go” criteria)

The quality shortcut that backfires

  • Skipping curl/length consistency checks across multiple trays (a single perfect sample ≠ stable batch)

What “launch-ready” means (deliverables)

  • Product photos (hero + side profile + band close-up)
  • SKU naming + barcode/SKU system
  • Claims-safe listing copy
  • Shipping cartons + packing list format
  • Reorder trigger plan (before you sell out)

Timeline at a glance (X-week template)

WeekWhat you must decideWhat you produceCommon delayGo / No-Go criteria
Week 0 (Prep)SKUs, hero SKU, spec boundaries, packaging routeLocked inputs“Let’s brainstorm more”Decisions finalized in writing
Week 1Style references → measurable specsSpec-locked sample briefSpec creepCurl/diameter/length map/band defined
Week 2Approval rules (tolerances)Sample round + pass/failSubjective feedback loopsCurl/length tolerance + band integrity pass
Week 3Packaging dieline + barcode + copyPackaging proof(s)Proof cyclesPrint-ready dieline + barcode verified

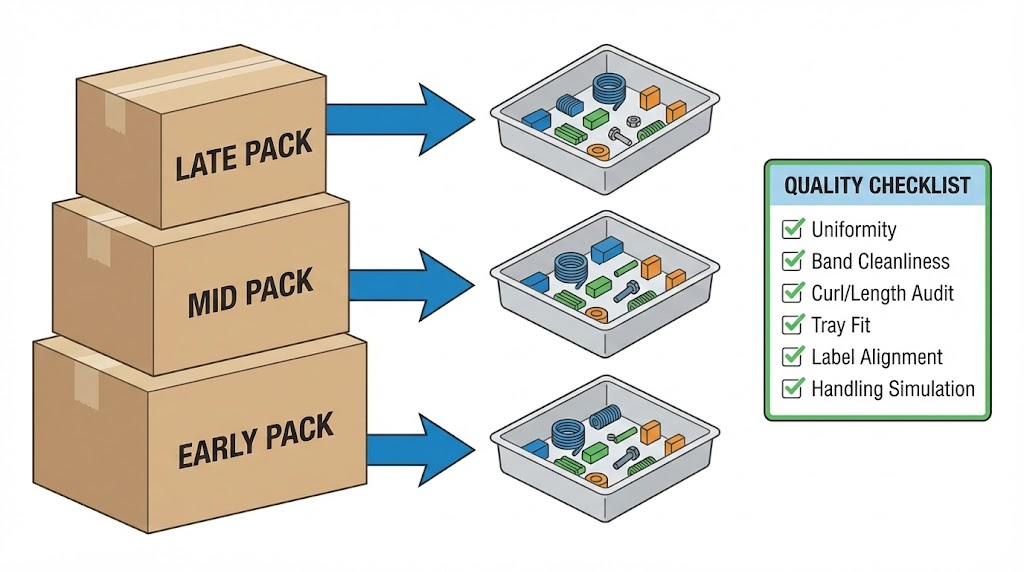

Week 4Pilot QC planPilot batch + QC auditBatch surprisesRandom tray checks pass
Week 5Listings, photos, logisticsLaunch assets + carton plan“Not glamorous” tasks ignoredListing + photos + shipping docs complete

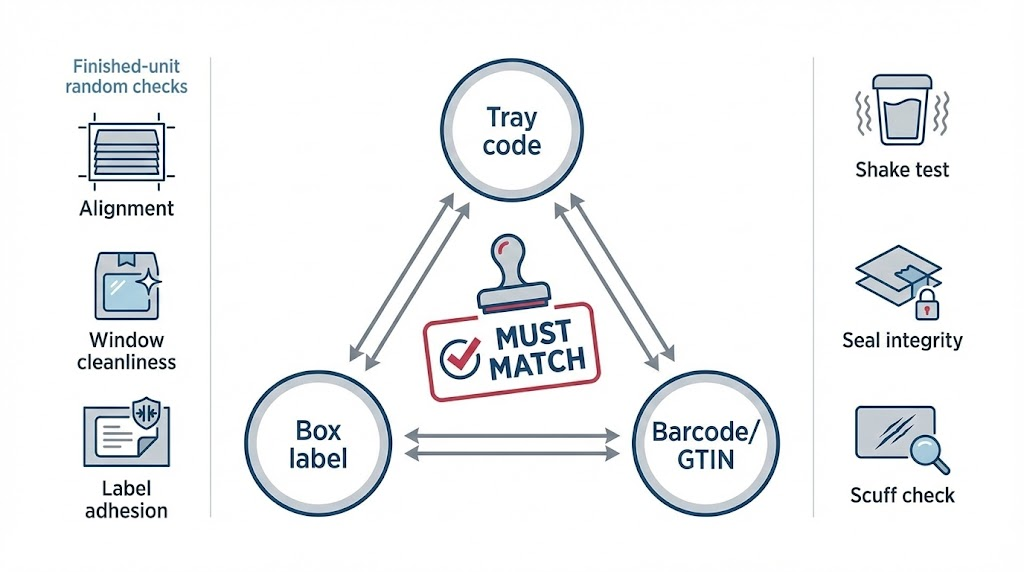

Week 6Final QA + go-live planFinished goods + pre-launch QALast-minute mismatch errorsSKU↔barcode↔tray code match; transit checks pass

Citable takeaway: The critical path is approvals → packaging proofs → pilot QC → launch assets, not “production.”

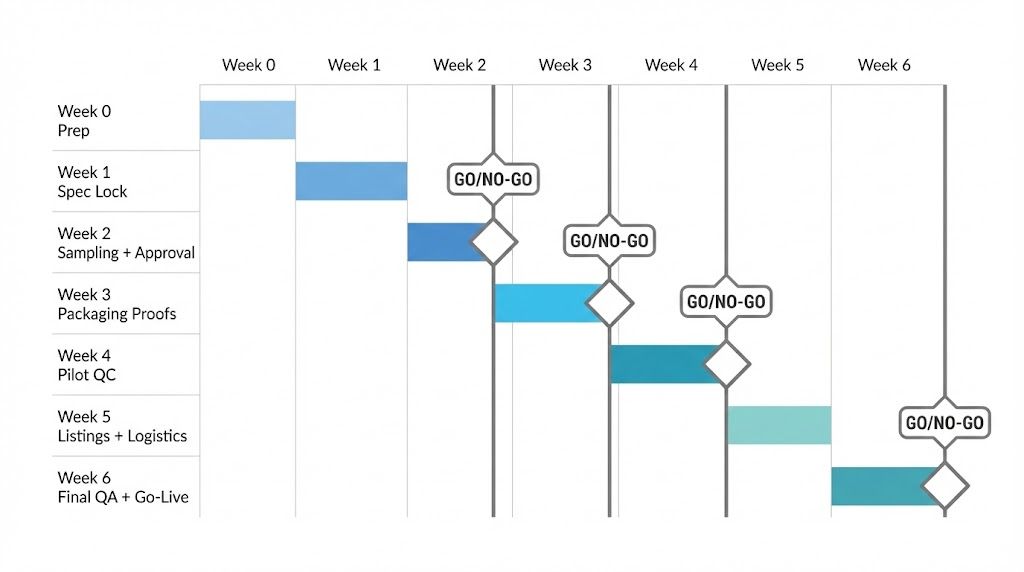

Week by week Gantt chart template for launching private label lashes

The Project Snapshot (What We Were Building)

We’ll call the brand Luna Studio Lashes (anonymized). Their goal was a clean, modern lash line for everyday wear and light glam—priced mid-tier, sold via Shopify and a small salon network.

Target launch scope

  • 3 SKUs (everyday, wispy, soft glam)
  • One core fiber look (faux-mink style finish)
  • Two lengths per SKU (e.g., 10–12 mm and 12–14 mm maps)
  • Packaging: branded lash box + outer mailer carton
  • MOQ: kept low to reduce risk and test sell-through
  • Non-negotiables: stable quality, consistent curl, clean tray presentation

Primary keyword focus (for SEO): concept to launch private label lashes


Week-by-Week Timeline: How “X Weeks” Actually Happens

Below is the 6-week version—the same flow can compress or stretch depending on approvals and customization depth.

Week 0 (Prep): The Decisions That Prevent Week 4 Panic

Before production even starts, we asked for five “locked” decisions:

  1. SKU count + hero SKU (what must be ready even if others slip)
  2. Lash spec boundaries (curl, diameter, length range, band style)
  3. Packaging approach (stock + label vs fully custom printed box)
  4. Brand assets (logo files, fonts, color codes, tone of voice)
  5. Launch channel needs (Shopify photos, barcodes, bundle strategy)

Actionable takeaway: If you want speed, reduce decisions that require physical samples (custom finishes, special foils, complex inserts) until after launch.

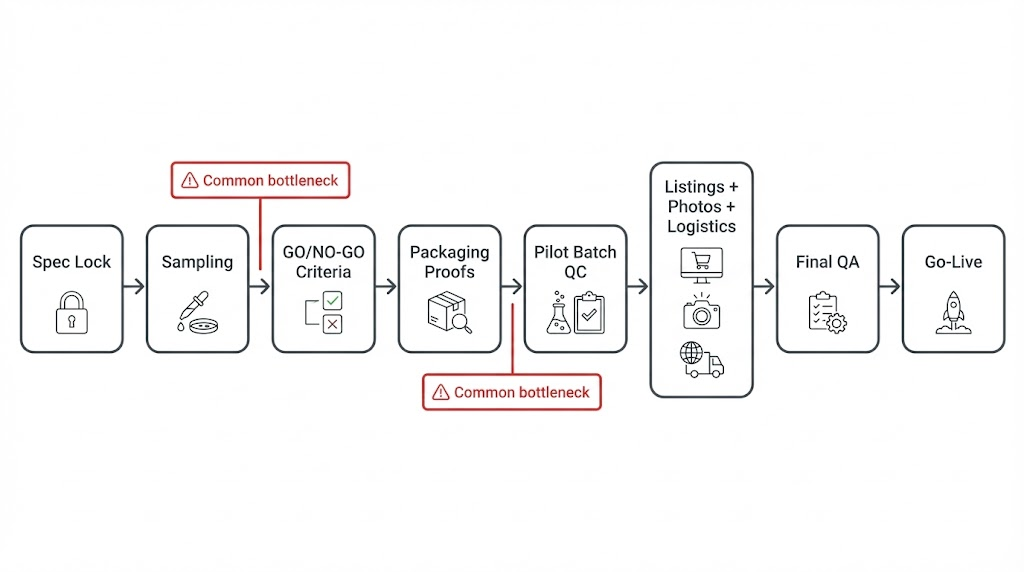

Flowchart showing critical path steps for private label lash launch timeline

Week 1: Concept, Sampling, and Spec Lock (Decision Sprint)

Goal of Week 1: turn “a vibe” (natural, wispy, doll-eye) into measurable specs your factory can produce consistently—so sampling doesn’t loop and your launch timeline stays intact.

Week 1 deliverables (what you should have by Friday)

  1. A Style Board (8 references) + notes on what you’re matching
  2. A 1-page Spec Lock Sheet (fiber, curl, diameter, length map, band, finish)
  3. A SKU naming system that matches photos and avoids customer confusion
  4. A change-control rule: what can still change in Week 2 vs what’s locked

Why this matters for speed and trust: Cosmetic GMP frameworks emphasize defined specifications + controlled processes to protect quality and reduce variability.

Step 1) Build a Style Board (8 references that “mean something”)

Pick references that represent the actual looks you want to sell, not aspirational images you can’t replicate.

Include (minimum):

  • 2 “everyday/natural”
  • 2 “wispy”
  • 2 “soft glam”
  • 2 “shape references” (doll-eye vs cat-eye)

For each reference, write one sentence:

  • “This is wispy because ____ (spacing + taper + density).”
  • “This is natural because ____ (shorter length map + softer curl + lower density).”

This is how you prevent subjective feedback later (“make it more natural”) from turning into endless resamples.

Step 2) Translate “vibes” into measurable specs (the Spec Lock Sheet)

A fast private label lash launch is less about “finding the perfect lash” and more about locking measurable specs early—so the factory can produce repeatable samples and batches.

Spec Lock Sheet (copy/paste template)

Record these as exact values (or allowed ranges) before samples are made:

A) Fiber / finish

  • Fiber polymer: typically PBT (a thermoplastic polyester commonly used for engineered fibers).
  • Finish target: matte / soft sheen / glossy
  • Color target: jet black / soft black / brown-black (if applicable)

Why PBT gets used: it’s a well-characterized polyester/engineering plastic that can be processed into consistent fibers.
(If you want a “curl memory” claim internally, keep it as an internal performance goal unless you can substantiate it for consumers.)

B) Curl

  • Curl family: B / C / CC / D (choose 1–2 only)
  • Curl priority: comfort vs drama (your brand positioning)

C) Diameter

  • Choose from your factory’s standard diameter options
  • State the intent: “comfort-first” vs “bold density”

D) Length map

  • List the exact length map(s) per SKU (e.g., 10–12mm map, 12–14mm map)
  • Specify shape: doll-eye / cat-eye / rounded

E) Band

  • Band type: clear / black / cotton thread / etc. (factory standard naming)
  • Band requirement: “clean edges, no visible residue, uniform thickness”

F) Tray presentation

  • Tray fit requirement: lash should sit flat; minimal lift during transport
  • Peel test expectation: should release cleanly and re-seat without deforming

Step 3) Lock a SKU naming system that matches photos

This is a quiet CTR + conversion lever: customers click and buy when the product name maps cleanly to what they see.

Simple naming format (works for Shopify + ads):
[Collection] – [Look] – [Curl] – [Map]
Example: Luna Core – Wispy – CC – 10–12

Rules:

  • If the map changes, the SKU name changes.
  • If the curl changes, the SKU name changes.
  • Avoid “creative” names until after your naming is operationally reliable.

Factory-side insight #1: Spec creep is the silent timeline killer

When brands say “natural”, they may mean:

  • thinner diameter,
  • shorter length map,
  • lower density,
  • softer curl,
  • more taper,
  • less shine.

So we treat “natural” as a definition exercise and lock specs before sampling. This aligns with GMP thinking: quality improves when you define what you’re making and control the inputs/processes rather than relying on subjective inspection alone.

Anti–spec-creep rules (use these in Week 1)

Detailed specification lock and tolerance reference: Eyelash Extension Thickness Guide + Lash Quality Control Tolerances + QC Checklist

  • Change only one variable per sample round (e.g., curl OR map OR band—never all three).
  • Create a Must-Have / Nice-to-Have list:
    • Must-Have = if this fails, it’s a hard no
    • Nice-to-Have = iterate later (post-launch v2)

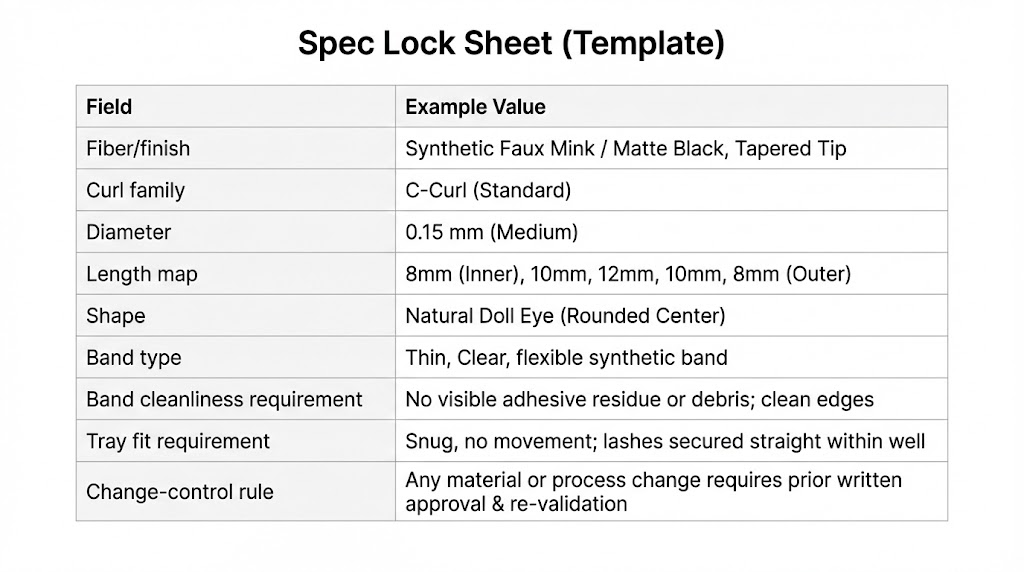

Spec lock sheet template for private label lashes including curl diameter length map band and finish

Week 2: Sampling Round + Approval Rules (So You Don’t Re-sample Forever)

Goal of Week 2: turn “vibes” into objective acceptance criteria so sampling doesn’t loop.

What you should have before you review samples

  • Spec sheet (curl, length map, band style, fiber finish target)
  • Reference board (your 6–10 photo references)
  • Approval scorecard (the same questions every time)

This “same checklist every time” approach mirrors how formal inspection systems keep outcomes consistent across lots. For brands that want a standards-based model, acceptance sampling frameworks commonly use an AQL (Acceptance Quality Limit) to define acceptable defect rates and sampling rules.

1) The sampling plan (simple + repeatable)

Don’t judge a whole run from the single “best” tray.

Do this instead (low-MOQ friendly):

  • Pull multiple trays across the set (not adjacent trays from the same carton).
  • Include at least:
    • one tray from early packing,
    • one mid-pack,
    • one late-pack (or from different cartons).
  • Take quick photo evidence (top view + side profile + band close-up) per tray.

Why: ISO cosmetic GMP guidance is built around controlling and checking product quality through production, storage, and shipment—not only “one perfect sample.”

2) Approval rules (your “go/no-go” scorecard)

Use three decision outcomes so feedback is actionable:

Decision outcomes

  • GO: Meets spec and reference intent → proceed to pilot/production
  • GO with minor edits: Small change allowed without changing tooling or restarting sampling (ex: slightly reduce shine)
  • NO-GO / Re-sample: Anything that affects wear, consistency, or returns risk (curl mismatch, length spikes, band residue)

The 5 non-negotiable checks (what your team signs off on)

A) Curl consistency (tray-to-tray)

  • No “mixed curl” look within a tray or between trays of the same SKU.

B) Length map integrity

  • No random spikes outside the intended map that change the silhouette.

C) Fiber finish

  • No overly shiny “plastic reflection” under typical product lighting.

D) Band integrity + cleanliness

  • Band sits flat, clean cut, no visible residue that affects comfort or adhesion.

E) Wear intent match

  • “Everyday” should read as everyday in photos and on-eye (not unexpectedly dense or dramatic).

Citable snippet: Sampling stays on schedule when approvals are tied to repeatable criteria (curl, length map, finish, band integrity, wear intent)—not subjective “looks good” feedback.

Sampling plan and defect prevention inspection: Lash Quality Control Tolerances + Prevent Eyelash Defects in Bulk

3) Why “C curl” isn’t enough (curl retention is process + handling)

Two trays can both be labeled “C curl” and still behave differently because shape in thermoplastic fibers is influenced by:

  • batch-to-batch finishing,
  • heat-setting parameters,
  • mechanical compression during storage,
  • temperature swings during transit.

Heat-set thermoplastic filaments can relax/shrink when exposed to temperatures above their glass transition (even far below melting), changing perceived shape over time.

Practical check (no lab tools):

  • Compare curl and silhouette across multiple trays, not the “best” one.
  • Add a quick handling check: peel/re-seat one cluster section and ensure the curl/look remains consistent.

4) “Transit reality” mini-check (prevents surprise complaints)

If your brand ships DTC, include a quick stress sanity-check before approving a final sample:

  • 24-hour rest in the final tray + box (simulates storage time)
  • light compression (stacked cartons) + basic drop/vibration exposure (simulates parcel handling)

Transport test standards commonly model hazards like vibration, drops, and atmospheric conditioning (e.g., wet/frozen conditions), which is why it’s smart to validate shape + presentation beyond a single untouched tray.

5) Actionable takeaway (the anti-re-sampling rule)

Approve with tolerances. Write down:

  • what’s “acceptable,”
  • what’s “not acceptable,”
  • and what changes are allowed without restarting sampling.

If you don’t define those boundaries, every revision becomes subjective—so sampling cycles keep repeating.

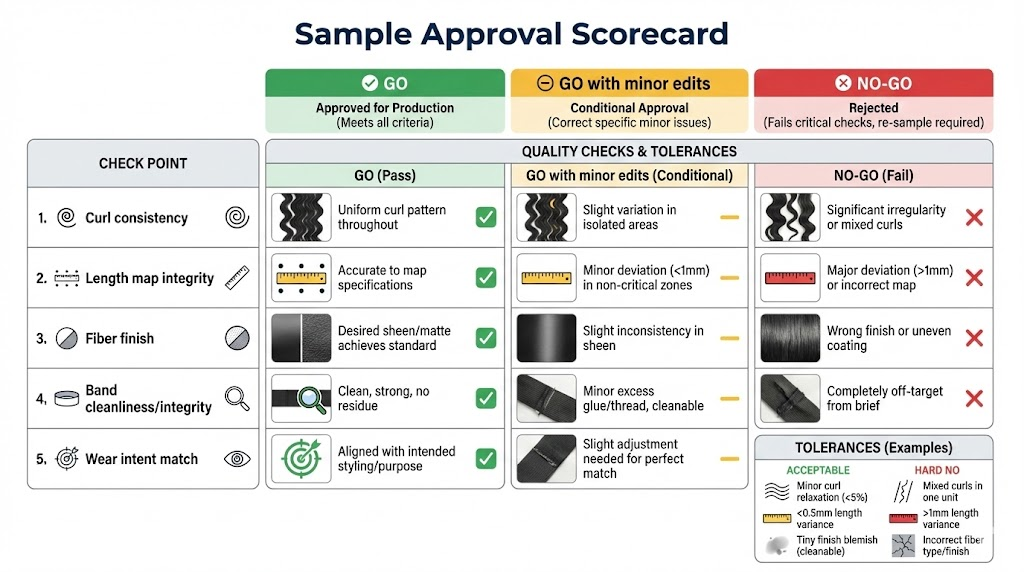

Sample approval scorecard with go no-go criteria for private label lashes

Week 3: Packaging & Labeling (Where Most “X-Week” Launches Slip)

Even when the lashes are ready, you can’t ship without approved, print-ready packaging—and packaging lead times (plus proof cycles) are a common reason launches drift from “6 weeks” to “10+.”

What this week is really about

By the end of Week 3, you want one “print-ready” packaging packet that’s approved and internally consistent:

  • Dieline (the structural blueprint showing cut/fold/bleed/safe zones)
  • Final artwork placed on the dieline, plus proof approvals (colors, fonts, bleeds, alignment)
  • Labeling text checked for compliance basics (outer carton/box is usually the “label” that matters most)
  • Barcode + SKU system finalized (ideally GS1-issued IDs for uniqueness and retailer/marketplace compatibility)

The packaging plan that kept us on track

Option chosen: semi-custom packaging (fast + branded)

  • Stock box structure (fast because the structure is already tooled and production-ready)
  • Custom printed sleeve or premium label (brand-forward without waiting on full custom box print cycles)

What we finalized (the “don’t let this float” list)

  1. Dieline placement
    • logo position, front panel hierarchy, window size, safe zones/bleed
      (A dieline is the packaging “blueprint” that ensures your artwork prints, cuts, and folds correctly.)
  2. Finish choice (kept simple)
    • matte + one accent (e.g., spot UV or foil)
      Why: every extra finish can add a proof/approval loop (and introduce more “is this the right shade?” debate).
  3. Barcode + SKU codes
    • We recommend getting barcodes from GS1 so the identifier is globally unique and tied to your company.
  4. Insert card (aftercare + brand story)
    • Great for perceived value, but treat it like marketing copy: keep claims specific, supportable, and consistent with your listing.

Labeling & claims basics (quick, practical, non-legal)

For lash packaging and inserts, the safest posture is: clear identity, clear contents, clear ingredients (when applicable), and claims that are truthful and not misleading.

If you sell in the U.S., make sure your outer packaging can support:

  • Net quantity of contents (required for cosmetics in package form; format depends on the product)
  • Ingredient declaration rules (and related cosmetic labeling requirements under 21 CFR Part 701)
  • Claims discipline: cosmetic labeling/claims must be truthful and not misleading; FDA does not “pre-approve” cosmetic claims.
  • Substantiation mindset: FTC guidance for advertising emphasizes that claims must tell the truth, not mislead, and be substantiated.

Practical rule for lash brands: if you can’t explain what you mean and how you’d support it in one sentence, rewrite the claim.

Factory-side insight #3: Packaging tradeoffs that affect timeline (and budget)

Why fully custom boxes take longer

Custom printed boxes tend to require more prepress + proofing + approval steps (artwork on dieline, color checks, bleeds/fonts, etc.), which increases cycle time and “revision risk.”

Why stock + sleeve/label is often the fastest “premium-enough” path

  • Stock structure = fewer structural decisions
  • Sleeve/label = you still get strong brand presence
  • Better for low MOQs because you’re not paying as heavily for full custom print setup and complexity on a first run (unit economics vary by supplier, but the pattern holds: more customization → more steps → more approval loops).

Mini decision guide (so Week 3 doesn’t slip)

Choose one packaging path and commit:

  • Stock box + custom label → fastest path to market
  • Stock box + printed sleeve → strong branding, moderate proof cycles
  • Fully custom printed box → premium retail feel, highest risk of timeline slip

Common delay points to avoid

  • “Can we see one more version?” without a go/no-go checklist
  • Unlocked brand assets (logo versions, fonts, color codes)
  • Barcode/SKU confusion late in the cycle (forces artwork edits)

Citable snippet

If launch speed matters, use a proven stock box structure and add branding with a premium label or sleeve—this reduces proofing loops while still delivering a cohesive, retail-ready presentation.

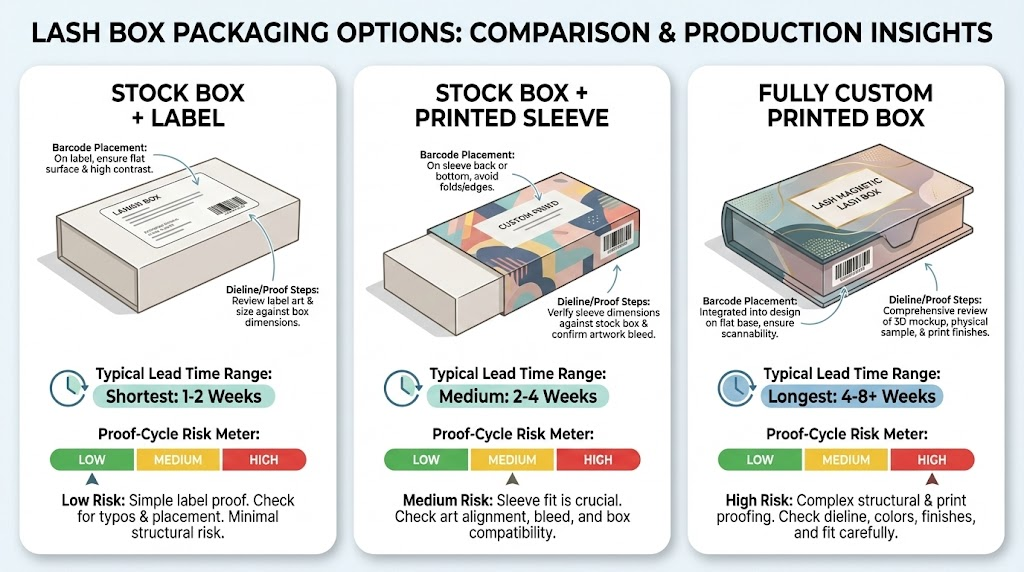

Comparison of private label lash packaging options with lead times and proof cycle risk

Week 4: Pilot Production (Pilot Run) + Batch-Level QC

Once lash specs and packaging proofs are approved, run a pilot batch (a small first production lot under the final process) before full-scale. This is basic GMP thinking: you’re verifying the process is repeatable at batch level—not just perfect in a single sample.

Citable snippet: A pilot batch de-risks launch because it tests real batch variability (materials, operators, packing, transit) before you commit to the full run.

What the pilot should produce (deliverables)

  • QC report + pass/fail decision (release / rework / hold)
  • Final spec sheet (curl, length map, band, tray fit) + tolerances
  • Traceability: lot/batch code mapping for trays, boxes, and cartons (so issues can be isolated quickly)

How to sample (so it’s not a “best-case” inspection)

Don’t inspect only the easiest cartons. Pull random units across cartons (top/middle/bottom; early/mid/late in packing).

If you want a formal method, use acceptance sampling/AQL concepts (common in manufacturing inspection) and document your chosen plan; ISO’s sampling standards describe lot-by-lot sampling schemes indexed by AQL.

Pilot QC checklist (practical, repeatable, citation-friendly)

CheckHow to test (simple)What to record (for “go/no-go”)Why it matters
Visual uniformityCompare left/right lash symmetry; compare across multiple traysDefine defect types (minor/major/critical) + photo examplesPrevents “same SKU looks different” returns
Band cleanliness + integrityMagnified look + light tug testNo visible residue, fraying, split bands; note rate of defectsBand defects drive complaints and negative reviews
Curl + length audit (batch-level)Check multiple trays from different cartonsYour tolerances (e.g., “no mixed-curl appearance”; length-map variance limits)A single tray can lie; batch reveals reality
Tray fit + presentation“Tap + tilt” test; ensure lash doesn’t pop looseTray holds lashes securely; no lifting/shiftReduces damaged-looking unboxings
Label/pack alignmentInspect barcode placement + adhesion after handlingMisalignment rate; adhesion failures; scuffsPrevents fulfillment and scanning issues
Handling simulationGentle peel + re-seat (like a customer)Band stays intact; lash shape doesn’t collapseTests real-use durability
Transit risk (lightweight version)Short “shake test” + drop from small height (packaged)Any tray shift, scuffing, seal failureShipping damage is a hidden launch killer; formal testing frameworks exist for shipping units

Optional “formalize it” note: If you later sell through stricter retail/3PL channels, you can align transit validation to packaging performance frameworks (e.g., ASTM D4169) rather than only informal shake tests.

Batch-level QC and transport protection: Prevent Eyelash Defects + QC Tolerances Checklist

Why the pilot matters (in one paragraph)

A single pre-production sample can be flawless; a batch exposes variability—material lots, heat-setting parameters, packing handling, label adhesion, and transit scuffs.

GMP-style guidance for cosmetics emphasizes controlled production, documented checks, and handling nonconformities—exactly what the pilot phase supports.

Pilot batch QC sampling diagram for private label lashes with random tray checks and defect checklist

Week 5: Content, Compliance Basics, and Logistics (The “Not Glamorous” Week)

Goal (why this week exists): while production runs, you build the launch infrastructure that prevents (1) returns from mismatched expectations, (2) compliance/claims issues, and (3) stockouts caused by slow reordering.

Week 5 outputs (what “done” looks like)

By end of week 5, you should have:

  1. Photo shot list + brief (so your images match the exact SKU/spec)
  2. Listing-ready copy (name, bullets, what’s included, how-to-use, cautions)
  3. Claims & labeling guardrails (what you will not say)
  4. Shipping + receiving docs (master carton labels + packing list format)
  5. Reorder trigger (based on lead time + velocity, not vibes)

1) Product photography direction (reduce returns + improve click confidence)

Non-negotiable principle: photos should accurately represent the specific SKU being sold (curl look, map/length range, band style). This protects trust and reduces “not as expected” returns. Google also emphasizes high-quality images for a good user experience and notes that multiple high-quality images are strongly correlated with better user outcomes in shopping contexts.

Minimum shot list (works for Shopify + salon wholesale line sheets)

  • Hero shot (front, clean, accurate curl/shape)
  • Side profile (shows curl + silhouette)
  • Close-up of band (clean cut, no residue, flexibility)
  • Tray + label (SKU name visible; prevents “wrong lash” confusion)
  • Scale/context (optional but helpful: on-eye photo or map graphic that matches the lengths you sell)

Citable snippet: If your photos don’t clearly show curl/shape and band detail, customers fill in the gaps—and returns go up.

2) Listings (SKU naming + benefit bullets + “what’s in the box”)

SKU naming rules (keep it scannable + unambiguous)

Use a consistent structure so customers can compare quickly:

  • Collection / Style name + map/length range + finish + band type
    Example: Everyday Wispy • 10–12 mm • faux-mink finish • flexible band

Benefit bullets template

  • Look: (everyday / wispy / soft glam)
  • Best for: (short liner / natural volume / light glam)
  • Map/length range: (e.g., 10–12 mm or 12–14 mm)
  • Band: (flexible, clean-cut; comfort focus)
  • Finish: (soft faux-mink style)
  • In the box: (pair count, tray type, insert card if included)

Tip: keep your first 1–2 bullets concrete (measurable) before “vibe” language—this improves excerpting for AI answers and helps shoppers decide faster.

3) Claims sanity-check

A) Avoid “drug-like” claims

If you imply treating/preventing disease or affecting the body’s structure/function, you can accidentally shift your product into drug-claim territory under U.S. definitions. Keep lash claims in the lane of appearance and cosmetic use.

Avoid: “heals,” “treats irritation,” “prevents infection,” “stimulates growth,” “safe for sensitive eyes” (as a guarantee).
Safer: “designed for everyday wear,” “lightweight feel,” “comfortable band,” “remove if irritation occurs.”

B) Substantiate objective claims (even “simple” ones)

For any objective claim you make (durability, performance, “hypoallergenic,” “latex-free,” “formaldehyde-free,” etc.), you should have a reasonable basis before publishing. That’s the FTC’s core advertising substantiation principle.

Practical rule: if you can’t point to a spec sheet, supplier documentation, or internal test result, soften or remove the claim.

Citable snippet: Make only claims you can support with a reasonable basis before you publish—especially safety/performance statements.

Label compliance, logo placement, SKU structure, barcodes and warning messages: Lash Brand Checklist: Logo Placement, Naming & Compliance

Claims & sensitive eyes guidance → Lash Adhesive Safety & Claims

C) Labeling basics (US-focused, non-legal)

If you’re selling in the U.S., FDA provides a labeling guide and summary requirements (identity, net quantity, ingredient declaration, etc.).
If you sell internationally, requirements vary—treat this as a starting checklist, not legal advice.

4) Logistics: master cartons + packing list (so receiving doesn’t break your launch)

Even if you’re “small,” your first operational failure is usually receiving chaos: miscounted cartons, mixed SKUs, or missing paperwork.

Packing list (simple format that scales)

A packing list documents what’s in the shipment and how it’s packed (carton numbers, item counts, weights/dimensions). It’s also used for checks at multiple stages, and some destinations require it for customs.

Include at minimum:

  • PO number / shipment reference
  • SKU + SKU name
  • Units per carton + number of cartons
  • Carton # (1 of N), gross weight, carton dimensions
  • Total units + totals (weight/cartons)

Master carton label (what to print on every carton)

If you want to be “retail-ready” later, align carton identification to widely used logistics labeling standards (GS1 has guidance for identifying logistics units).

Minimum carton label fields (human-readable):

  • Brand + PO/reference
  • SKU(s) inside (or “mixed”)
  • Qty per SKU + total qty
  • Carton number (e.g., 3/12)
  • Lot/batch code (if you use one)
  • Destination (your warehouse / 3PL)

Optional (future-proof): add serialized carton IDs (useful for 3PLs and audits).

5) Reorder triggers (don’t use a %—use a formula, then translate to a %)

Your original “30–40% remaining” rule is a decent heuristic, but to be more trustworthy and repeatable, anchor it to standard inventory logic:

Reorder point (ROP) = demand during lead time + safety stock.

Simple way to implement (no tools required)

  1. Estimate average weekly sales per SKU (or conservative forecast).
  2. Confirm lead time in weeks (production + freight + receiving buffer).
  3. Pick a small safety stock buffer (to cover demand spikes or delays). ASCM describes safety stock as a buffer against variability and forecast error.
  4. Reorder when:
    On-hand ≤ (avg weekly sales × lead time) + safety stock

Translation into an easy rule: once you compute ROP, you can express it as a rough “% remaining” for your first run. The % varies by lead time and sales speed—so it’s more reliable than a fixed 30–40% for everyone.

Citable snippet: Low MOQ lowers risk, but it shortens your runway—so reorder timing should be set from lead time demand + safety stock, not a generic percentage.

Product photography shot list for private label lashes hero side profile band close up tray label

Week 6: Final Assembly, Pre-Launch QA, and Go-Live (Return-Prevention Week)

Week 6 is about one thing: shipping units that arrive clean, match the correct SKU, and don’t create avoidable customer complaints—especially for eye-area products.

Goal for Week 6

A launch is “ready” when you can confidently say:

  1. The product + packaging match the SKU (no mix-ups),
  2. Labels are correct and durable,
  3. Units survive basic transit stress,
  4. You can trace and fix issues quickly (batch/lot + QC notes).

Pre-Launch QA Checklist (Minimum-Viable, but Standard-Aligned)

1) Random finished-unit checks (from sealed cartons)

What we pulled: a small random sample from each SKU’s finished cartons (enough to catch obvious assembly drift).

What we checked (pass/fail):

  • Packaging alignment: tray sits straight; window looks intentional (no skew)
  • Window cleanliness: no scratches, dust, fingerprints
  • Label adhesion: label corners don’t lift after light rubbing
  • Scuff risk: outer surface doesn’t mark easily with normal handling

Why this matters: Packaging defects are among the easiest “silent killers” of first-run reviews and returns—and they’re cheapest to catch before shipping.

Citable takeaway: Pre-launch QA should inspect finished, sealed units—not just pre-assembly components—because most early returns are caused by packaging presentation, SKU mismatches, and transit damage.

2) Label sanity-check (don’t let “launch week” create compliance debt)

For cosmetics sold in the U.S., labeling is regulated (identity of the product, net quantity, business name/place, and other required elements depending on your product/claims).

What we verified in Week 6 (quick but effective):

  • The SKU name on the label matches the product listing name (reduces customer confusion)
  • Any warnings / directions are consistent across box, insert, and PDP copy
  • The label is readable at normal viewing distance and won’t smudge easily

Operator note: This isn’t legal advice—just a “launch hygiene” check so you don’t have to reprint labels immediately after go-live.

3) SKU match verification (3-way “no-mistakes” rule)

We ran a simple 3-way match before any units left the building:

tray code ↔ box label ↔ barcode/GTIN

If you’re using barcodes for retail or marketplace workflows, use legitimate, globally unique identifiers (GS1 GTINs) to avoid downstream listing and inventory issues.

Pass criterion: If any one of the three doesn’t match, the unit is quarantined until resolved.

4) Transit risk checks (simple tests, mapped to real standards)

Even a “pretty” product fails if the tray shifts, the window scuffs, or seals pop during shipping.

What we did (fast, operator-friendly):

  • Shake test: does the tray shift, pop loose, or shed fibers?
  • Seal integrity: does the closure scuff, crease, or open under light stress?
  • Drop awareness: would a typical small-parcel drop dent corners or crack windows?

Why we can justify these checks: Packaging test standards like ISTA procedures and ASTM D4169 exist specifically to simulate common transport hazards (shock/vibration/handling) and reduce damage in distribution.

(You don’t have to run full certification testing for a small launch, but aligning your checks to these hazard categories improves reliability and documentation.)

5) Eye-area customer safety readiness (returns + reputation protection)

Because lashes/adhesives are used around a delicate area, we confirmed the launch assets included:

  • Clear “stop use if irritation occurs” guidance
  • A simple support path for complaints (so problems don’t become public reviews first)

FDA’s consumer guidance emphasizes that adverse reactions around the eye area can be significant and should be handled conservatively.

Go-Live Plan (Soft Launch → Observe → Scale)

After QA passed, Luna’s team scheduled:

  • Soft launch (email + socials)
  • Salon partner seeding (controlled feedback loop)
  • First bundle promo (3-SKU set)

What we monitored in the first 7–14 days:

  • Return reasons (SKU mismatch vs packaging damage vs comfort complaints)
  • Repeated “same issue” signals (suggests batch/assembly problem)
  • FAQ gaps (what customers keep asking = what your PDP didn’t clarify)

Documentation we kept (trust + scalability):

  • QC log + photo examples of pass/fail
  • Batch/lot notes tied to SKUs
  • Packaging proof version used at launch
    This kind of production/control/shipment documentation aligns with widely used cosmetics GMP guidance like ISO 22716.

Result: They launched on time with 3 SKUs and a clean first-run presentation—then used customer feedback to plan the next drop (new curl + one bolder map).

Pre-launch QA diagram showing SKU match verification and transit shake test for private label lash packaging

Common Mistakes (and Fixes) We See in “X-Week” Launches

  1. Too many SKUs too soon
    • Fix: Launch 2–4, then expand after you see sell-through.
  2. Approving samples without criteria
    • Fix: Approve with “must-have” rules + tolerances.
  3. Packaging perfectionism
    • Fix: Use stock + label/sleeve for the first run; go fully custom later.
  4. Ignoring tray + band details
    • Fix: Band cleanliness and tray fit reduce returns.
  5. No plan for reorder timing
    • Fix: Set reorder triggers (e.g., when inventory hits 30–40%).

More factory perspectives on avoiding pitfalls: Wholesale vs Private Label Lashes Guide + How to Choose a Lash Manufacturer


Quick Checklist: Launch Private Label Lashes in X Weeks

  • Decide SKU count + hero SKU
  • Lock specs: fiber, curl, diameter, length map, band style
  • Approve sample with criteria + tolerances
  • Choose packaging approach (stock+label vs custom print)
  • Finalize barcode/SKU system
  • Run pilot batch + batch-level QC
  • Confirm tray fit + transit stability
  • Prepare product photos + listing copy
  • Create reorder trigger plan
  • Final QA on finished packaged units

FAQ

How fast can a private label lash brand launch, realistically?

If you use proven specs and simpler packaging, 4–6 weeks is often realistic. Fully custom packaging, more SKUs, and slow approvals can push timelines to 8–10+ weeks.

What slows launches down the most?

Packaging proof cycles, unclear sample feedback, and adding new custom elements midstream (special finishes, custom inserts, unusual box structures).

Can we launch with a low MOQ and still look premium?

Yes. Premium feel comes from consistency, clean finishing, and smart packaging choices (like sleeves, matte labels, good tray presentation), not just expensive box printing.

Do we need to worry about sensitive eyes in product copy?

Keep claims conservative and customer-friendly. If customers report irritation, advise them to stop use and seek professional guidance. (We can share general, evidence-informed guidance, but if you have persistent irritation, swelling, pain, or vision changes, please stop use and consult an eye-care professional.)

When should we reorder?

Set a trigger before you’re low—many brands reorder when inventory hits 30–40% remaining, depending on lead time and sales velocity.


Key Points

  • Launch speed is mostly about decision speed, not production speed.
  • Keep first drops small: 2–4 SKUs is easier to execute cleanly.
  • Approve samples with measurable criteria (curl, length tolerance, band finish).
  • Packaging is the biggest variable—stock + label/sleeve can launch fast and still look branded.
  • Batch-level QC prevents costly returns and reputation damage.
  • Low MOQ reduces risk, but you need a reorder plan earlier.
  • A pilot run is a smart “insurance policy” before full packaging assembly.

Conclusion: How to Hit “X Weeks” Without Cutting Corners

If you want to go from concept to launch in X weeks, the path is straightforward:

  1. lock specs early, 2) approve with rules, 3) keep packaging practical, 4) QC at batch level, 5) prepare launch assets while production runs.

That’s exactly how Luna Studio Lashes hit a 6-week launch—without skipping the unglamorous steps that protect customer experience.

If you want, we can help you map a timeline based on your exact scope (SKU count, packaging complexity, MOQ target) and recommend the fastest route that still delivers stable quality, customized lash styles, and factory-direct pricing.

Ready to map your own timeline? We can help you develop the fastest and most compliant private label route based on your SKU quantity, packaging complexity, and MOQ target.

→ Get an OEM/ODM quote & customization suggestions now or contact us


Comparison Table (Speed vs Customization)

ChoiceFastest timelineBest forTradeoff
Stock box + custom label4–6 weeksFirst launch, low MOQLess “luxury unboxing”
Stock structure + printed sleeve5–7 weeksBrand-forward but fastSleeve proof cycles
Fully custom printed box7–10+ weeksPremium retail positioningLonger print lead time + higher cost at low MOQ

References

U.S. Food & Drug Administration (FDA). (n.d.). Summary of cosmetics labeling requirements.

U.S. Food & Drug Administration (FDA). (n.d.). Code of Federal Regulations sections for cosmetics labeling (CFR Title 21, Part 701).

Electronic Code of Federal Regulations (eCFR). (n.d.). 21 CFR Part 701 — Cosmetic labeling.

U.S. Food & Drug Administration (FDA). (n.d.). Eye cosmetic safety.

U.S. Food & Drug Administration (FDA). (n.d.). Registration & listing of cosmetic product facilities and products (MoCRA).

U.S. Food & Drug Administration (FDA). (n.d.). Guidance for industry: Registration and listing of cosmetic product facilities and products.

International Organization for Standardization (ISO). (2007). ISO 22716:2007 — Cosmetics — Good Manufacturing Practices (GMP) — Guidelines on good manufacturing practices.

International Organization for Standardization (ISO). (2026). ISO 2859-1:2026 — Sampling procedures for inspection by attributes — Part 1: Sampling schemes indexed by acceptance quality limit (AQL) for lot-by-lot inspection.

GS1. (n.d.). Get a barcode (GTIN/barcode guidance).

International Safe Transit Association (ISTA). (n.d.). Test procedures (packaged-product transit testing procedures).

ASTM International. (2022). ASTM D4169-22: Standard practice for performance testing of shipping containers and systems.

Federal Trade Commission (FTC). (n.d.). FTC policy statement regarding advertising substantiation.

Konishi, T., & Miyamoto, Y. (2010). Smectic structure and glass transition in poly(butylene terephthalate). Polymer Journal, 42, 349–353.

SpecialChem. (n.d.). Polybutylene terephthalate (PBT) plastic: Material guide & properties.

Zoey Lee

OEM EyeLash Project Manager

At LashVee, we help lash brands and professional buyers avoid common sourcing mistakes—from inconsistent curl and fiber quality to unstable band bonding in mass production. Our work focuses on translating design intent into repeatable, production-ready lash styles.

If you’re evaluating suppliers, refining a lash design, or planning a private label order, we’re happy to share practical input or provide samples to support your decision.

Recent Post
Four connected LashVee DIY lash clusters showing the natural curved band after lifting
Curved-Band DIY Lash Clusters: OEM Sample Checklist
cat eye lash extensions.pic
The Ultimate 2026 Lash Technician Salary Guide: Which U.S. States Pay the Most?
Faux Mink vs Real Mink Lashes
Faux Mink vs. Real Mink Lashes: Which One Should You Choose?
faux-mink-eye-closeup
2026 TikTok Eyelash Extension Trends
China vs Korea Lash Manufacturers
China vs Korea Lash Manufacturers: Which Is Better for Your Brand?

Zoey Lee

OEM EyeLash Project Manager

At LashVee, we help lash brands and professional buyers avoid common sourcing mistakes—from inconsistent curl and fiber quality to unstable band bonding in mass production. Our work focuses on translating design intent into repeatable, production-ready lash styles.

If you’re evaluating suppliers, refining a lash design, or planning a private label order, we’re happy to share practical input or provide samples to support your decision.
